Tuesday, July 21, 2009
Monday, July 20, 2009
Construction Update - July 20, 2009
Reactor charge pump being installed.
Foundation for the off-gas compressor.
Hydroisomerizer cold separator.
Hydroisomerizer cold separator.
Monday, July 13, 2009
Construction Update - July 13, 2009
We now have over 92,000 safe work hours!! Things continue to move along despite the summer heat and humidity. Here are some pictures of what is happening now---
Forming up the containment around the raw material tanks.
Arrival of the cooler skid.
Unloading the cooler skid.
Hydrogen compressor and cooler skids in place.
Wednesday, July 1, 2009
Construction Update - June 30, 2009
Remember the hydrogen compressor on the June 19 update? Well, testing in the shop went well and here it is at the plant.
Thursday, June 25, 2009
Construction Update - June 25, 2009
Just some general pictures in this update. There is a lot of work happening with making spool pieces and putting piping in the pipe racks. Next week we will be setting the hydrogen compressor which was pictured in the June 19 update.
This is another air cooler.
Foundation for the reactor charge pump.
Foundation for the steam deaerator.
The LPG bullet looks much better since we cleaned it.
Tuesday, June 23, 2009
Construction Update - June 23, 2009
Last weekend the construction crew worked the night shift to beat the heat. Here are the foundations for the hydrogen compressor and cooler skid being poured. They started at 1 am and finished pouring before the sun came up.
Friday, June 19, 2009
Construction Update - June 19, 2009
It is officially sunny and hot in Geismar! Here are a few more pictures on what is happening.
We now have stairs to the top of the raw material tanks.
This is the compressor assembled for testing before being shipped to the site.
Building pipe racks....
The last of the foundations being formed to pour...
We now have stairs to the top of the raw material tanks.
This is the compressor assembled for testing before being shipped to the site.
Friday, June 5, 2009
Construction Update - Diesel Tanks
Here are a couple of interesting pictures of the roof supports for one of the diesel tanks.
Thursday, June 4, 2009
Site Overviews
Wednesday, May 27, 2009
Construction Update - May 8, 2009
The power up of the 480v system is now complete. We also now have lights in the plant offices.
Here is the foundation for the hot oil heater being formed up.
An inside view of a raw material tank.
Construction Update - LPG Tank
The weather has been cooperating and we have been able to take advantage of it. Here is the LPG tank being put on the foundations.
Construction Update - May 2, 2009
All the major foundations in the west processing area are now complete. The east/west pipe rack is now 100% complete and ready for pipe to be installed.
These are the raw material tanks.

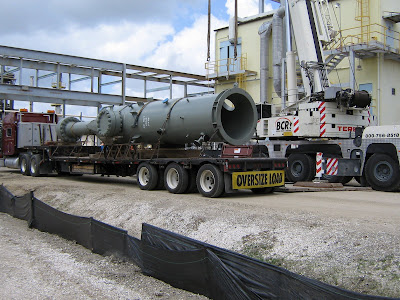

One of the separators being put in place.
Friday, May 1, 2009
Construction Update - April 30, 2009
Things have been progressing quite well since the last update.......
And here is the first pipe going in the pipe racks:
Thursday, April 23, 2009
Construction update - April 12, 2009
We have had over 18,000 safe work hours since the end of January!!
- 90% complete on excavation of the West Process Area
- Started steel erection for the east/west pipe rack.
- All piles have been completed.
East / West Pipe Rack
Piles for the HDO reactors.
Tuesday, April 21, 2009
